Wedding Planning Timeline From Engagement to Wedding Day
Building your guest count and budget first prevents costly venue mistakes later.

A couple gets engaged, starts pricing venues, and within a few months finds the number has climbed meaningfully past what they first budgeted. That gap between the first estimate and the final invoice isn't bad luck. It comes from decisions made in the wrong order, at the wrong moment, before the information needed to make them well was actually in hand.
Wedding costs in Australia have climbed sharply from one year to the next, and the rate of that climb has itself sped up compared to the year before. A couple researching prices at engagement is pricing a market that will have moved by the time they book.
Guest count drives the budget more than any other single factor. Adding or removing ten guests shifts the total by thousands of dollars. The guest list is the financial decision that has to happen first, because nothing downstream prices correctly without it.
Most couples get this backwards. They fall for a venue, sign the contract, and only then start building the guest list, which locks in a per-head cost before anyone has actually counted the heads. A sequence that puts budget and guest count ahead of any venue conversation closes that gap before it opens.
The logic of the phase sequence: why each decision must gate the next
A wedding planning timeline works as a chain of dependencies that must be followed in order. Budget constrains guest count. Guest count constrains which venues can even work. Venue constrains the date. Date constrains which vendors are still available. Pulling any one of these out of order means the rest has to be redone, usually at a worse price and under more pressure.
The sequence that holds up runs budget and guest count first, then date and venue, then the legal notice, then vendors, then stationery and guest communication, then final logistics, then day-of handover. Each phase produces a small number of decisions that have to be locked before the next phase can open honestly. Skipping that locking step results in double-booked vendors, headcounts that don't match what was sent to the caterer, and a seating chart built three times instead of once.
Keeping the guest list, the budget, and the seating chart connected rather than living in four separate spreadsheets matters for the same reason. When a guest count changes, the budget total, the seating layout, and the headcount sent to the caterer all need to move with it. A system where those numbers update together prevents the quiet errors that come from updating one spreadsheet and forgetting the other three.
Phase 1 (at engagement): fixing your budget ceiling and your real guest count before anything else
The first week after getting engaged should produce exactly two numbers: a budget ceiling and a firm guest count. Without both, a venue quote is just a number with nothing to compare it against.

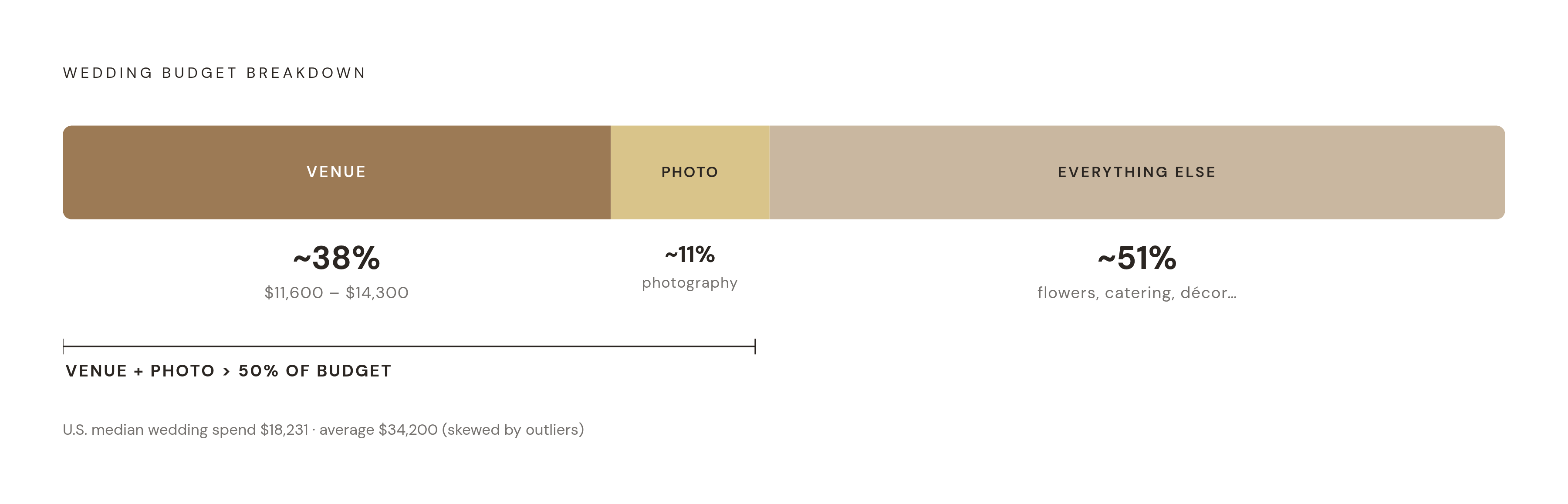

Start the budget with what can actually be spent. National averages hide enormous variation by city. A couple planning in Sydney is working with different per-head economics than a couple in Brisbane or at a regional venue an hour outside a capital. Sydney typically runs higher than Melbourne, Melbourne runs higher than Brisbane, and Adelaide and Perth tend to offer better value among the capitals. Regional venues and suppliers come in lower again than their city equivalents.
The date itself is a budget lever most couples don't think to pull this early. A Friday evening or Sunday wedding can cut venue cost substantially compared to a Saturday in peak season. Spring, from September through November, and autumn, from March through April, are the two windows when the best venues and photographers book out furthest ahead, which pushes prices up and choice down for anyone planning inside them.
Guest count needs the same treatment as a financial decision, not a social one. Cost per head stays remarkably consistent regardless of state, so every name added to or cut from the list moves the total by a predictable dollar amount. Couples tend to land on a guest count smaller than what they first imagined once the budget math gets real. Do that math before falling in love with a venue that can't actually hold the number of people the budget allows, not after signing a contract built around a guest list that hasn't been finalized.

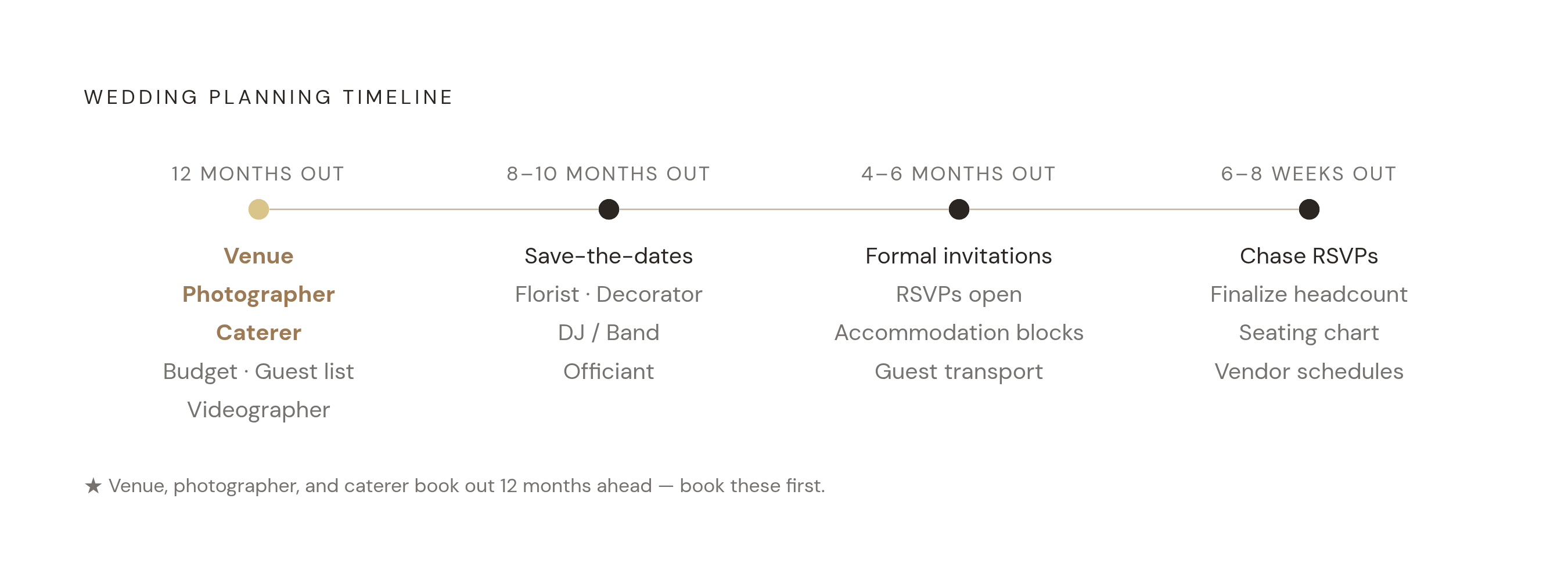

Phase 2 (12 months out): locking the date and venue while the choice still exists
Peak-season venues and the photographers couples most want to book fill 12 to 18 months out. A couple who waits until 9 months before the wedding to start venue conversations is choosing from whatever popular dates are left over.
The date itself still carries budget weight at this stage. Spring and autumn remain the peak windows in Australia, booked out furthest in advance by the venues and photographers in highest demand. Summer and winter dates open up both availability and pricing, so choosing when to get married is still, in part, choosing how much to spend.
Booking the venue locks in constraints that can't be undone later. It sets the maximum and minimum guest count the space can hold, which needs to match the firm number from Phase 1. It sets the catering model, whether food comes in-house from the venue or from an external caterer brought in separately. It often sets a list of approved vendors the couple has to choose from, narrowing Phase 3 before it even starts.
Sydney venue pricing shows how much geography inside a single city matters. All-inclusive packages that bundle catering, beverages, and coordination vary widely even between venues in the same metro area. Inner-city and harbour venues run materially higher per head than options out in Western Sydney, so the suburb matters almost as much as the city.
One request belongs in the venue conversation now, even though it won't matter for months: a scaled floor plan showing table configurations, maximum legal capacity, dance floor and stage placement, service doors, and any pillars or sightline obstacles. That document becomes essential when the seating chart gets built, and it's far easier to request before a contract is signed than to chase down afterward.
Phase 3 (10–12 months out): booking the vendors who fill first
Photographers, celebrants, and caterers book out earliest of any vendor category, and all three should be locked in before the 10-month mark. Everything else can follow once those three are confirmed.
The priority order matters because availability doesn't move evenly across categories. Photographer, celebrant, and caterer come first. Videographer, florist, and band or DJ follow once the first three are settled, since they tend to have more flexible calendars closer to the date.
Deposits typically run 10 to 30 percent of the total upfront, with the balance due somewhere between one and four weeks before the wedding. A budget tracker needs to show both numbers for every vendor: what's already been paid as a deposit, and what's still outstanding. Tracking only the total quote hides how much cash actually needs to be available in the weeks right before the wedding.
Ask about fuel surcharges directly in 2026. Any vendor traveling to the venue, photographer, florist, band, may be absorbing higher transport costs than their quote originally reflected. Ask upfront whether the quote already includes travel and whether a fuel surcharge applies on top of it, so the number compared across vendors is the number that will actually land on the invoice.
Comparing quotes gets easier when every vendor's numbers sit in the same format: total fee, deposit amount, balance due date, what's included, and travel policy. A scattered inbox of PDFs and emails makes it nearly impossible to compare three caterers fairly. A consistent structure makes the comparison take minutes instead of hours.
Phase 4 (8–10 months out): sending save-the-dates and lodging the legal notice
Two tasks get forgotten or pushed too late more than any others in the entire timeline: telling guests to hold the date, and lodging the legal paperwork that makes the marriage official. Both belong at the 8-to-10-month mark, not later.
Save-the-dates should go out 8 to 10 months before the wedding for local guests, and a full 12 months ahead for destination weddings or guests traveling internationally. Every save-the-date should carry the wedding website address, so guests have somewhere to check back as details firm up over the following months.
The Notice of Intended Marriage is the legal step most often missed or left until it's genuinely risky. Australian law requires couples to lodge the NOIM with their authorised celebrant at least one month before the wedding date, and no more than 18 months before it. That one-month minimum is a legal floor, and the wedding cannot legally proceed if it isn't met.
Lodging the NOIM at 8 to 10 months out leaves comfortable room to fix anything that comes back wrong, a misspelled name, a missing document, a date error. Waiting until 3 months out removes that margin. If something needs correcting at that point, there may not be enough runway left before the legal minimum kicks in.
Save-the-dates only do their job if there's a live website behind them. By this phase, the site should already show the date, the venue's city, nearby accommodation options, and an RSVP form that asks about dietary needs and feeds directly into the guest list. A separate form that has to be manually copied into the guest list later just creates a second data entry job and a second place for mistakes to hide.
Phase 5 (6–8 weeks out): sending invitations and setting a firm RSVP deadline
Invitations should go out 8 to 10 weeks before the wedding, with a firm RSVP deadline set 4 to 6 weeks out. Expect a further week of chasing stragglers after that deadline passes before the guest list counts as final.
Destination or international guests need more runway than local ones. Invitations for those guests should go out 10 to 12 weeks ahead rather than 8 to 10, giving enough time for flights and visas to get sorted before the deadline arrives.
The RSVP deadline itself needs to be stated clearly in two places: on the invitation and on the wedding website. Setting the date isn't the end of the work. A week of following up with people who haven't responded is normal practice. Identifying who hasn't replied should happen automatically from the guest list data, not by manually cross-checking a spreadsheet against a pile of reply cards on the kitchen table.
Three things need to come back from every RSVP: whether the guest is attending, their meal choice, and any dietary requirements. All three need to be recorded per person, not per household, because catering kitchens route meals by individual seat, not by family unit.
Digital invitations offer a real advantage over paper at this phase. Tracking delivery, opens, and RSVP status as they happen, rather than waiting for physical reply cards to trickle back through the mail, shortens the follow-up cycle and puts an accurate headcount in hand earlier than paper ever allows.
Phase 6 (3–4 weeks out): building the seating chart from confirmed guest data
The seating chart shouldn't start until the RSVP deadline has passed and the headcount is confirmed. Starting earlier means rebuilding the whole layout as latecomers trickle in, which is wasted effort stacked right on top of the most stressful month of the entire process.
Two things need to be in hand before anyone touches a layout. The first is a confirmed guest list with dietary requirements recorded per person. The second is the scaled floor plan requested from the venue back in Phase 2, showing table shapes and capacities, dance floor placement, service doors, pillars, and any sightline obstacles in the room.
Dietary needs have to be tracked at the individual seat level. Vegan guests, gluten-free guests, and anyone with an allergy need to sit where a server can find them without scanning every table in the room looking for the right plate.
A seating chart needs a minimum set of fields to actually function: guest name, table number, RSVP status, dietary requirements, and which side of the wedding party the guest belongs to, bride's family, groom's family, friends, or work. Adding meal choice, accessibility notes, and plus-one names on top of that makes the chart genuinely useful to the caterer and the venue coordinator on the day.
The right tool for this job depends entirely on guest count. Under 50 guests, a paper diagram or a basic spreadsheet is genuinely enough to get the job done. At larger guest counts, an AI-assisted placement tool can save hours of manual trial and error moving names between tables. At 150 guests or more, pairing that kind of tool with direct collaboration from the venue coordinator keeps the layout realistic against the room's actual constraints, not just theoretically correct on a screen.
